Wastewater Infrastructure Rehabilitation Project

Week Ahead, 2/25-3/6

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues on Promontory & the North End of the Pointe
            ⚬ REMINDER: Keep plumbing traps (P-Traps) filled with water

✔ Contractors will soon begin demobilizing trailer & select equipment next to spit tennis court

Week Ahead, 2/18-2/27

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues on Promontory & the North End of the Pointe
            ⚬ REMINDER: Keep plumbing traps (P-Traps) filled with water

✔ Contractor work on the bluff is concentrated at the new lift station (around Portage)

Week Ahead, 2/11-2/20

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues on Promontory & the North End of the Pointe
            ⚬ REMINDER: Keep plumbing traps (P-Traps) filled with water

✔ Contractor work on the bluff is concentrated at the new lift station (around Portage)

Week Ahead, 2/4-2/13

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues on Promontory & the North End of the Pointe
            ⚬ REMINDER: Keep plumbing traps (P-Traps) filled with water

✔ Contractor work on the bluff is concentrated at the new lift station (around Portage)

✔ Congestion on Pointes Drive East around Portage is expected on Thursday, Feb. 5th with heavy equipment on-site

Week Ahead, 1/28-2/6

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety, grinder pump installations began and will continue in the months ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues throughout the Pointe
            ⚬ REMINDER: Keep plumbing traps (P-Traps) filled with water

✔ Contractor work on the bluff will resume as weather allows

Week Ahead, 1/21-1/28

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety, grinder pump installations began and will continue in the months ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues throughout the Pointe

✔ Contractor work on the bluff will resume as weather allows

Week Ahead, 1/7-1/16

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety, grinder pump installations began Monday, 11/17 and will continue in the months ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues throughout the Pointe

✔ No work will be conducted the week of 12/22-12/26; work on 12/29-12/31 dependent on weather

✔ Contractor work on the bluff will resume as weather allows

Week Ahead, 1/7-1/16

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety, grinder pump installations began Monday, 11/17 and will continue in the months ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues throughout the Pointe

✔ No work will be conducted the week of 12/22-12/26; work on 12/29-12/31 dependent on weather

✔ Contractor work on the bluff will be limited to connection of existing laterals and installation of grinder pump lids, until weather allows for resuming grinder pump placement

Week Ahead, 12/17-12/26

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety, grinder pump installations began Monday, 11/17 and will continue in the months ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues throughout the Pointe

✔ No work will be conducted the week of 12/22-12/26; work on 12/29-12/31 dependent on weather

✔ Contractor work on the bluff will be limited to connection of existing laterals and installation of grinder pump lids

Week Ahead, 12/10-12/19

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety, grinder pump installations began Monday, 11/17 and will continue in the months ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues throughout the Pointe

✔ No work will be conducted the week of 12/22-12/26

✔ No bluff work through December 14—future work dependent on weather conditions

Week Ahead, 12/3-12/12

✔ Pointes Drive East Traffic Control Revision:
Effective immediately, traffic control for Pointes Drive East, between Portage and Bos'n Roads, has been revised—in addition to access for local residents, local deliveries may now resume to homes within this area

✔ East Bluff Trail (Portage to Bos’n) remains completely closed for your safety, grinder pump installations began Monday, 11/17 and will continue in the months ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues throughout the Pointe

✔ No work will be conducted the week of 12/22-12/26

Week Ahead, 11/19-11/26

PLANS PENDING for PAVING as early as November 11 for PDE between Barbary & Portage, depending on weather and contractors

ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
Pedestrian/bike/golf cart access restricted


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety as grinder pump installations began Monday, 11/17 and will continue in the weeks ahead

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues at the south & west areas of the Pointe

✔ No work will be conducted on 11/27 & 11/28

✔ No work will be conducted the week of 12/22-12/26

Week Ahead, 11/5-11/14

PLANS PENDING for PAVING as early as November 11 for PDE between Barbary & Portage, depending on weather and contractors

ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
Pedestrian/bike/golf cart access restricted


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety as grinder pump installations are underwaty

HPMA Fines now enforced for violation of road & trail closure signs

✔ Iron Horse pipe lining continues at the south & west areas of the Pointe

Week Ahead, 10/29-11/7

CONTINUED PAVING PREP: on Pointes Drive East this week and Nov. 3-4

ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Connecting 348 lateral to new lift station Nov. 5-6

✔ Iron Horse pipe lining continues at the south & west areas of the Pointe

✔ Possible paving from Barbary to Portage on Nov. 5-6, depending on weather and contractors

Week Ahead, 10/8-10/17

ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Electrical work for the new pump station at the base of Portage Road continues

✔ Iron Horse pipe lining continues at the south end of the Pointe

✔ Drilling for pipe & electrical conduit to PDE Bluff residences between Portage & Bos'n

Week Ahead, 10/1-10/10

ROAD PAVING: on Nantucket Rd. on Mon., Oct. 6 & Tues. Oct. 7, Disruption also affects Cutty Sark & RV Access Road, READ MORE »
ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Electrical work for the new pump station at the base of Portage Road continues

✔ Iron Horse pipe lining continues at the south end of the Pointe

✔ Drilling for pipe & electrical conduit to PDE Bluff residences between Portage & Bos'n

Week Ahead, 9/24-10/3

ROAD PAVING: on Nantucket Rd. on Tues., Sept. 30 & Wed. Oct. 1, Disruption also affects Cutty Sark & RV Access Road, READ MORE »
ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Electrical work for the new pump station at the base of Portage Road continues

✔ Iron Horse pipe lining continues at the south end of the Pointe

✔ Drilling for pipe & electrical conduit to PDE Bluff residences between Portage & Bos'n

Week Ahead, 9/17-9/26

ROAD PAVING: on Nantucket Rd. on Tues., Sept. 30 & Wed. Oct. 1, Disruption also affects Cutty Sark & RV Access Road, READ MORE »
ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Electrical work for the new pump station at the base of Portage Road continues

✔ Iron Horse pipe lining continues at the south end of the Pointe

✔ Drilling for pipe & electrical conduit to PDE Bluff residences between Portage & Bos'n

Week Ahead, 9/10-9/19

ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail (Portage to Bos'n) remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Electrical work for the new pump station at the base of Portage Road is underway

✔ Iron Horse pipe lining continues at the south end of the Pointe

✔ Drilling for pipe & electrical conduit to PDE Bluff residences between Portage & Bos'n

Week Ahead, 9/3-9/12

ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Grading of Nantucket road in preparation of future paving

Week Ahead, 8/27-9/5

ROAD CLOSED: Pointes DR. E between Portage & Bos'n

Resident & Guest access only
No pedestrian/bike/golf cart access


Direct package deliveries to clubhouse
No delivery trucks prior to scheduling with GM
Possible delay in use of common driveway
Consider parking outside of construction zone (8-5) as work approaches your driveway

✔ East Bluff Trail remains completely closed for your safety

HPMA Fines now enforced for violation of road & trail closure signs

✔ Grading of Nantucket road in preparation of future paving

Week Ahead, 8/20-8/27

Full road closure on PDE at Portage for extensive work on new pump station, discharge piping and new manhole placement in the weeks ahead. NO EXCEPTIONS FOR PASSAGE. A sewer bypass system has been placed north of Portage to prevent disruption to sewer service during the work.

HPMA Fines now enforced for violation of road & trail closure signs
✔ Initial sewer lining excavation to begin on common driveways at the South end of Barnacle
✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P) Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
✔ Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times

Week Ahead, 8/13-8/20

Full road closure on PDE at Portage for extensive work on new pump station, discharge piping and new manhole placement in the weeks ahead. NO EXCEPTIONS FOR PASSAGE. A sewer bypass system will soon be placed north of Portage to prevent disruption to sewer service during the work.>

✔ Extensive work to progress on PDE north toward BOS’N over the course of the months ahead
✔ Initial sewer lining excavation to begin on common driveways at the South end of Barnacle
✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P) Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
✔ Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times

Week Ahead, 8/6-8/13

Full road closure on PDE at Portage for extensive work on new pump station, discharge piping and new manhole placement in the weeks ahead. NO EXCEPTIONS FOR PASSAGE. A sewer bypass system will soon be placed north of Portage to prevent disruption to sewer service during the work.>

✔ Extensive work to progress on PDE north toward BOS’N over the course of the months ahead
✔ Initial sewer lining excavation to begin on common driveways at the South end of Barnacle
✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P) Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
✔ Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times

Week Ahead, 7/30-8/6

Full road closure on PDE at Portage for extensive work on new pump station, discharge piping and new manhole placement in the weeks ahead. NO EXCEPTIONS FOR PASSAGE. A sewer bypass system will soon be placed north of Portage to prevent disruption to sewer service during the work.>

✔ Extensive work to progress on PDE north toward BOS’N over the course of the months ahead
✔ Initial sewer lining excavation to begin on common driveways at the South end of Barnacle
✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P) Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
✔ Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times

Week Ahead, 7/23-7/30

Full road closure on PDE at Portage for extensive work 7/21-7/25, NO EXCEPTIONS

✔ Extensive work to progress on PDE north toward BOS’N over the course of the months ahead
✔ Initial sewer lining excavation to begin on common driveways at the South end of Barnacle
✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P) Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
✔ Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times

Week Ahead, 7/16-7/23

✔ Service lines & conduit for new grinder pumps will be tied into force main on PDE for lots 392-416
✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P) Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
✔ Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times
✔ Initial sewer lining excavation to begin on common driveways at the South end of Barnacle

Full road closure on PDE at Portage for extensive work 7/21-7/25, NO EXCEPTIONS
✔ Extensive work to progress on PDE north toward BOS’N over the course of the months ahead

Week Ahead, 7/9-7/16

✔ Service lines & conduit for new grinder pumps will be tied into force main on PDE for lots 392-416
✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P)
Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times
✔ Saw cutting along PDE for grinder pump conduit
✔ Initial sewer component lining to begin on driveways at Barnacle BLVD & Liberty RD
✔ Full road closure on PDE at Portage for extensive work 7/21-7/25

Week Ahead, 7/2-7/9

✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P)
Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ Excavation in PDE continues, with focus on lots #350–392
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access
Delivery by large truck or contractor work must be scheduled in advance with the District GM
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times
✔ Electrical contractors (Betschart) will install conduit in open trenches on PDE for power to future grinder pumps
✔ *No work is scheduled Thurs., July 3 through Sun., July 6

Week Ahead, 6/25-7/2

✔ PDE remains closed to pedestrian, bike, and vehicle traffic during work hours (8A-5P)
Resident Only Access is provided within safe limits, with direction from construction workers on site
✔ Attend to road conditions/obstacles if you must drive through construction zones, reducing speed and accommodating pedestrians in the narrowed roadway
✔ East Bluff Trail remains completely closed for your safety, please obey signage at all times
✔ Excavation in PDE continues, with focus on lots #350–392
✔ Electrical contractors (Betschart) will install conduit in open trenches on PDE for power to future grinder pumps
✔ Surveyor (Sound Survey) will be present along PDE on Thurs., June 26
✔ Manholes continue to be rehabilitated by Pro-Vac.
✔ *No work is scheduled Thurs., July 3 through Sun., July 6
✔ *PDE residences between Portage and Bos’n should direct all deliveries to clubhouse or other accessible location due to limited street access

Week Ahead, 6/18-6/25

✔ Installation of force main and power conduit for grinder pumps in open PDE trench
✔ Service lines for new grinder pumps will be tied into force main on PDE for lots 350-378
✔ Provac will continue to prep & coat manholes needing rehabilitation
✔ The surveyor will be on-site again this week along Pointes Drive E
✔ Road closure on Pointes Drive E between Portage & Barbary to all vehicles, bikes & pedestrians—resident access only with potential delays, detour signs in place
✔ Pointes Dr. East residences between Portage & Barbary should plan to direct all deliveries to the HPMA clubhouse or another accessible delivery location while street access is limited
✔Transport of bedding rock to Pointes Dr. East
✔No contractor work is scheduled on July 4-6
✔The East Bluff Trail south of Bos’n is closed, Only Bos’n trailhead and stairs remain open
✔Large truck & contractor access to residences in construction areas must coordinate with Jeff, the District GM, in advance (see details at hpwsd.org or by calling the District office)

Week Ahead, 6/11-6/18

Road closure on Pointes Drive E between Portage & Barbary to all vehicles, bikes & pedestrians—resident access only with potential delays, detour signs in place

Pointes Dr. East residences between Portage & Barbary should plan to direct all deliveries to the HPMA clubhouse or another accessible delivery location while street access is limited

✔ Potholing to verify infrastructure depth on Pointes Dr. East

✔ Manhole rehab prep and coating continues throughout Pointe
(anticipate large trucks from Provac)

✔ Transport of bedding rock to Pointes Dr. East

✔ Portage trailhead access to bluff trail to be temporarily closed with signs

✔ No contractor work is scheduled on July 4-6

Week Ahead, 6/4-6/11

✔ Bypass sewer system on Nantucket was removed

✔ Nantucket sewer laterals being tied into the main to be completed June 4

✔ Cleanup of Nantucket Road begins Thursday, 6/5

Work begins Monday, 6/9, on Pointes Drive E between Nantucket & Barbary

Daytime road closure on Pointes Drive E between Nantucket & Barbary to through traffic—resident access only with potential delays, detour signs will be in place

✔ Potholing to identify buried infrastructure continues on Pointes Dr. East

✔ Manhole rehab prep continues and coating begins throughout Pointe
(anticipate large trucks from Provac)

✔ Transport of bedding rock to Portage Road

✔ East Bluff Trail between Portage & Bos’n to close as-needed with signage

Week Ahead, 5/28-6/4

✔ Bypass Sewer System on Nantucket to be removed

✔ A new manhole will be placed on Nantucket on Friday, 5/23

✔ Nantucket sewer laterals are being tied into the main

✔ Potholing to identify buried infrastructure continues on Pointes Dr. East

✔ Manhole rehab prep continues and coating begins throughout Pointe
(anticipate large trucks from Provac)

✔ Transport of bedding rock to Nantucket

✔ Temporary road closures will be posted in advance for duration of Nantucket work

✔ East Bluff Trail between Portage & Bos’n to close as-needed with signage

✔ Work to begin on Pointes Dr. East on June 9th

Week Ahead, 5/21-5/28

✔ Nantucket Sewer Main replacement continues with potential road closures

✔ A new manhole will be placed on Nantucket on Friday, 5/23

✔ Nantucket sewer will be camera-inspected and pressure tested next week

✔ Nantucket sewer laterals will be tied into the main starting next week

✔ Manhole rehab prep continues and coating begins throughout Pointe
(anticipate large trucks from Provac)

✔ Transport of bedding rock to Nantucket

✔ Temporary road closures will be posted in advance for duration of Nantucket work

✔ East Bluff Trail between Portage & Bos’n to close as-needed with signage

✔ Sewer camera work and lining of sewer mains is complete

Week Ahead, 5/14-5/21

✔ Nantucket Sewer Main replacement continues with potential road closures

✔ A new manhole will be placed on Nantucket on Friday, 5/16

✔ Manhole Rehabilitation Preparations throughout Pointe as of 5/5
(anticipate large trucks from Provac)

✔ Transport of bedding rock to Nantucket

✔ Temporary road closures will be posted in advance for duration of Nantucket work

✔ East Bluff Trail between Portage & Bos’n to close as-needed with signage

✔ Sewer Camera & Lining work continues at the North end of the Pointe

Week Ahead, 5/7-5/14

✔  Nantucket Sewer Main replacement continues

✔  Manhole Rehabilitation Preparations throughout Pointe as of 5/5
(anticipate large trucks from Provac)

✔  Transport of bedding rock to Nantucket

✔  Temporary road closures will be posted in advance for duration of Nantucket work

✔  East Bluff Trail between Portage & Bos’n to close as-needed with signage

✔  Sewer Lining work to resume Monday 4/28

✔  Potholing on Pointes Dr E @ Portage to Visualize Underground Utilities

✔  Sewer Camera & Lining work continues throughout the Pointe

Special Meeting, May 7, 2025

A special meeting is scheduled to provide updated information regarding the sewer rehabilitation project, specifically as it pertains to property owners along the bluff.  Contractors, project engineers and District personnel will be present to convey what owners can expect with regard to the sewer revision and grinder pump services and answer questions.

The meeting is scheduled for Wednesday, May 7, 2025 at 1:00 pm at the HPMA Clubhouse.  Homeowners or designated representatives are encouraged to attend.  For those who wish to join the meeting remotely, a link will be available on the District website at the time of the meeting.  The link will be prominently displayed on a red banner near the top of the website.

The purpose of the meeting is to:

  • Describe the East Bluff sewer revision project and provide updates
  • Explain what to expect in the months ahead and discuss its potential impact
  • Share a video demonstration of grinder pump operation
  • Address questions and concerns, as related to your specific lot​

Week Ahead, 4/30-5/1

✔  Nantucket Sewer Main Replacement
Potential for future emergency water shut offs still exists while sewer contractors work in close proximity to fragile water mains (please consider storing water for these brief outages; hot showers available at HPMA pool for anyone affected by this outage)

✔  Manhole Rehabilitation Preparations throughout Pointe as of 5/5 (anticipate large trucks)

✔  Transport of bedding rock to Nantucket

✔  Temporary road closures will be posted in advance for duration of Nantucket work

✔  East Bluff Trail between Portage & Bos’n to close as-needed

✔  Excavations started 4/30 to verify depths for grinder pumps among bluff homes

✔  Potholing on Pointes Dr E @ Portage to visualize underground utilities

✔  Sewer Lining work begins on Pointes Dr E, north of Bos'n

✔  Sound Surveyors will be on-site

Week Ahead, 4/23-4/30

✔  Nantucket Sewer Main Replacement
Potential for future emergency water shut offs still exists while sewer contractors work in close proximity to fragile water mains (please consider storing water for these brief outages; hot showers available at HPMA pool for anyone affected by this outage)

✔  Placement of new manhole in Nantucket

✔  Transport of bedding rock to Nantucket

✔  Temporary road closures will be posted in advance for duration of Nantucket work

✔  East Bluff Trail between Portage & Bos’n to close Monday 4/28, duration anticipated ~1 month (trail closure for excavation to measure depths for grinder pumps)

✔  Sewer Lining work to resume Monday 4/28

Week Ahead, 4/16-4/23

✔  Sewer Bypass system is in place on Nantucket Road

✔  Nantucket Sewer replacement scheduled to begin April 21
with partial daytime closures at Cutty Sark and additional saw cutting in preparation for new sewer main and manhole

✔  Increased truck traffic between Nantucket Road & commercial gate with equipment removing excavated materials

✔  Temporary road closures will be posted in advance for duration of Nantucket work

✔  Sewer Camera & Lining work ongoing

Week Ahead, 4/9-4/16

✔  Sewer Bypass system is being established on Nantucket Road
(to keep sewer service uninterrupted)

✔  Nantucket Sewer replacement scheduled to begin April 15
(to continue through April, possibly May)

✔  Activity to increase significantly on Nantucket Road with heavy equipment

✔  Any needed road closures will be posted in advance

✔  Sewer Camera & Lining work ongoing

Week Ahead, 4/2-4/9

✔  Small, targeted excavation/test holes in Nantucket Road to expose & identify buried utilities

✔  Small, targeted excavation/test holes in Pointes Dr. E near Portage Trail Head to expose & identify buried utilities

✔  Northwest Rock delivering backfill crushed rock to Maintenance Yard for use on Nantucket Road

✔  Piping & other parts will arrive for placement at Nantucket

✔  Sewer Camera & Lining work ongoing

Week Ahead, 3/26-4/1

✔  Portage Tree Removal Cleanup

✔  Small, targeted excavation/test holes in Nantucket Road to expose & identify buried utilities

✔  Saw cutting in Nantucket Road asphalt, shallow preliminary cuts

✔  Sewer Camera & Lining work ongoing

2/28/25 WIRP Updates: Ongoing Inspections & Cleaning Continue, CIPP Lining to Begin

2/28/25

Attention Hartstene Pointe Residents:

Work will continue on the sewer rehabilitation project in the coming weeks. The week of March 3rd will include new equipment and processes to the work that has already been underway. New crews will be on site to complete the Cured in Place Pipeline (CIPP) work to seal up the leaking sewers. Over the next week (3/3 to 3/7), crews will be installing the CIPP liner in Liberty Road and Barnacle Boulevard west of Pointes Drive East. The week of 3/10 to 3/14, the crew will be installing the CIPP liner in Nantucket from west of Pointes Drive East. This work will not include excavation and should not result in any road closures or access limitations. When they are installing the lining, the request that residents minimize toilet use, refrain from taking showers, running the dishwasher or doing laundry. The requested time for limited use should be 1 day maximum. You will receive a notice on your door letting you know when the requested limitation would be in place. We understand this can be a major inconvenience for residents and apologize for the necessity.

They will also continue the inspection work planned for the southern portions of Pointes Drive East as shown on the previous map. The inspection work will include large trucks that will be performing cleaning of the sewers in the street and another truck that will be performing video inspections of the sewer line after the cleaning. All of the equipment will be in the street and will have cones around it. No roads are anticipated to be closed and no digging or excavation will be taking place.

As they are performing the camera inspections, they may trace the sewer laterals toward the houses with their equipment so they can pinpoint the exact location of the sewer lateral. You may see workers around your property tracing the sewer lateral route. If you have any concerns about the workers, please reach out to Century West Engineering’s on-site representative, Steve Hallee at 425-626-3241 or the Hartstene Pointe Water and Sewer District office at 360-427-2413 to let them know about your concerns. Again, they will not be disturbing your property during this investigation, only establishing the location of your sewer service lines. No vehicles or equipment will be on or around your property as all equipment will be in the street.

The Contractor will ensure that vehicles can pass the equipment at all times unless there is a situation that can’t be avoided. This may include manholes that are in driveways. If the Contractor needs to close a driveway, the Contractor will provide at least 48 hours notice before making such a closure. The Contractor will provide a flyer to each house/residence that will be affected by the closure and also provide notification through the HPMA and HPWSD websites and email lists.

Additional updates will follow as the work progresses. Thank you for your patience through this construction process.

Updates will also be posted here on the website:
https://hpwsd.org/news/wirp

Any and all questions should be directed to the District General Manager, Jeff, at gm@hpwsd.org or (360) 549-6047 and not to HPMA.  Hartstene Pointe Water-Sewer District is not affiliated with HPMA.

2/24/25 Work to Begin on Liberty & Barnacle

2/21/25

Attention Hartstene Pointe Residents:

Work will begin on the sewer system rehabilitation project on Monday, February 24, 2025. This work will include large trucks that will perform cleaning of the sewers in the street followed by another truck that will perform video inspections of the sewer line after the cleaning.  All of the equipment will be in the street and will have cones around it.  No roads are anticipated to be closed and no digging or excavation will be taking place.

As workers are performing the camera inspections, they may trace the sewer laterals toward the houses with their equipment so they can pinpoint the exact location of sewer laterals.  You may see workers around your property tracing the sewer lateral route.  If you have any concerns about the workers, please reach out to Century West Engineering’s on-site representative, Steve Hallee, at 425-626-3241 or the Hartstene Pointe Water-Sewer District office at 360-427-2413 to let them know about your concerns.  Again, they will not be disturbing your property during this investigation, only establishing the location of your sewer service lines. No vehicles or equipment will be on or around your property as all equipment will be in the street.

The Contractor will ensure that vehicles can pass the equipment at all times unless there is a situation that can’t be avoided.  This may include manholes that are in driveways.  If the Contractor needs to close a driveway, the Contractor will provide at least 48 hours notice before making such a closure.  The Contractor will provide a flyer to each house/residence that will be affected by any closure and also provide notification through the HPMA and HPWSD websites and email lists.

The work will begin near the intersection of Liberty and Barnacle on February 24.  The included map has been provided as a means for you to track the camera work, by date (in red), as tentatively scheduled. The timeline is always subject to change and when changes occur, this map will be updated and notice provided  to the HPMA and HPWSD.

Additional updates will follow as the work progresses.

Thank you for your patience through this construction process.

Updates will also be posted here on the website:
https://hpwsd.org/news/wirp

Any and all questions should be directed to the District General Manager, Jeff, at gm@hpwsd.org or (360) 549-6047 and not to HPMA.  Hartstene Pointe Water-Sewer District is not affiliated with HPMA.

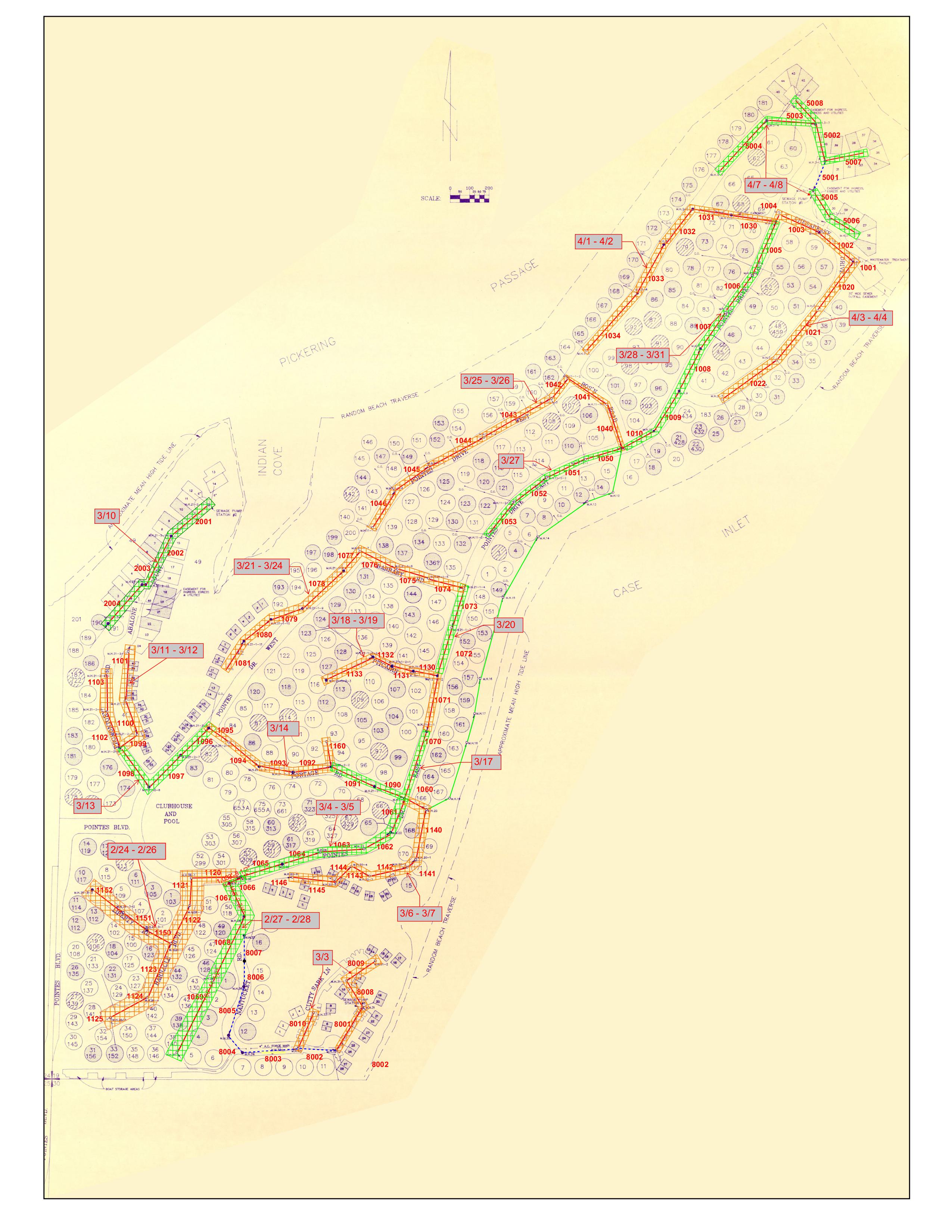

2025-02-21 WIRP Map Rev.jpg

Camera Work to Begin, Crews to Start 2/24/25

2/7/24

The next phase of WIRP, the Wastewater Infrastructure Rehabilitation Project (sewer project), is finally scheduled to begin on Monday, February 24.  The first stage of the project will involve camera work throughout sewer mains and laterals.  Homeowners can expect to see construction crews working throughout the Pointe—including individual properties—gathering video information of underground infrastructure in order to assist with future phases of the project.

It is not yet known where in the Pointe the work will begin or when/where work will progress, but as soon as more details are set, information will continue to be provided as early as possible.

Updates will also be posted here on the website:
https://hpwsd.org/news/wirp

Any and all questions should be directed to the District General Manager, Jeff, at gm@hpwsd.org or (360) 549-6047 and not to HPMA.  Hartstene Pointe Water-Sewer District is not affiliated with HPMA.

Construction Bidding Updates

Pre-bid & Bid Opening Meetings:

On Nov. 22, 2024, the District General Manager and project engineers met on-site with prospective contractors to respond to questions about the scope and specifics of the Wastewater Infrastructure Rehabilitation Project.  Attending this pre-bid meeting was a requirement for considering bids from contractors.

Bid submittals will be opened on Thursday, Dec. 19, 2024, at the HPMA clubhouse and bids will be reviewed and considered at the open, public meeting of the Board of Commissioners on the same day at 1:00 pm at the District's office.

Rev. 12/6/24

Public Hearing Scheduled, July 27, 2024

When: July 27, 2024 @ 10:00 am
Where: HPMA Clubhouse, 202 E Pointes Dr. E

District Commissioners, Administrative Staff and Century West Engineering hosted a hearing to share details about the Wastewater Infrastructure Improvements projects specifically focused on bluff infrastructure relocation and answered community members' questions as they were known.

Public Meeting was also available via teleconference

Presentation Slides »

Rev. 7/29/24

Public Hearing Scheduled, April 27, 2024

When: April 27, 2024 @ 10:00 am
Where: HPMA Clubhouse, 202 E Pointes Dr. E

District Commissioners, Administrative Staff and Century West Engineering hosted a hearing to share details about the Wastewater Infrastructure Improvements projects specifically focused on bluff infrastructure relocation and answered community members' questions as they were known.

Public Meeting was also available via teleconference

Presentation Slides »

Rev. 4/29/24

Public Hearing Scheduled, March 2, 2024

When: March 2, 2024 @ 9:00 am
Where: HPMA Clubhouse, 202 E Pointes Dr. E

District Commissioners, Administrative Staff and Century West Engineering hosted a hearing to share details about the Wastewater Infrastructure Improvements projects and answered community members' questions as they are known.

Public Meeting was also available via teleconference

Presentation Slides »

Rev. 3/5/24

Public Hearing Scheduled, Oct. 7, 2023

When: October 7, 2023 @ 9:00 am
Where: HPMA Clubhouse, 202 E Pointes Dr. E

District Commissioners, Administrative Staff and Century West Engineering hosted a hearing to share details about the Wastewater Infrastructure Improvements projects and answered community members' questions as they are known.

Public Meeting was also available via teleconference

Presentation Slides »

8/22/2023

The Wastewater Infrastructure Improvement Project is currently in it's Design & Planning phase.  The District and Century West Engineering secured a $1.3 million loan for this phase of the project and the District will automatically be considered for grant and loan commitments from Ecology for the Construction phase of the project.  The District is confident the Construction phase will be considered necessary for funding by Ecology.

CIPP LiningCIPP lining will be a major component for repairing damaged sewer pipes
